Change approval meetings: why every small change now needs one

You could build the change in an afternoon. Getting it through the change approval meeting takes a calendar invitation, a room of people and a wait for the next slot.

Author
Amit GovilFounder and CEO, XONIK
Published
October 22, 2026
Reading time
8 min read
In this piece
Download PDF

In brief

A small change ends up in a change approval meeting when what it touches is known only to people, because gathering them is the cheapest way to find out. The meeting then picks up authority, a growing invitation list and control of the pace. Written dependency contracts, with teams free to decide inside them, return routine changes to the team.

Key findings

  1. An unwritten dependency gets negotiated again in a meeting each time one side wants a change.

    Conway argued that a system's structure copies the communication structure of the organization that designed it, so every connection is a standing agreement between people. The meeting becomes a lookup of facts, done by hand.

  2. The meeting drifts from informing the change to approving it.

    Once an owner has been caught out by an unannounced change, a no becomes protection. The invitation list grows a name at a time and never shrinks, and the meeting's cadence starts setting the pace of change.

  3. External approval doesn't make changes safer.

    DORA's research found a negative effect on software delivery performance and no evidence that formal external review lowers the rate of failed changes. Heavyweight approval pushes toward larger batches released less often.

  4. Sorting what people say in the meeting shows what to write down, assign or send.

    A fact about a dependency belongs in a written contract, a judgment about risk belongs to a named owner with a stated rule, and news is a notice. The fact only one person holds is the fragility itself.

  5. Contracts between teams let a team decide alone again.

    A team may change anything inside its own part while the contract it keeps with the other parts holds. A contract test that fails when an output changes form gives the answer a meeting would have given.

Why does a small change end up in a change approval meeting?

Because the person making the change can't see what it touches, and the people who can are in different places. Change how a customer's status is calculated and billing, the portal, a report and a partner feed may all be affected. If knowledge of those dependencies is written down, the person reads it. If it sits in separate heads, the efficient way to consult everyone at once is a room. Calling them in is a sensible answer to a problem that a document should have solved.

Melvin Conway's 1968 paper explains why the facts end up scattered like this. He argued that organizations which design systems are constrained to produce designs that copy their own communication structures. Where one part of a system talks to another, the groups responsible for the parts must have negotiated and agreed an interface specification (How Do Committees Invent?, Datamation, April 1968). So every coupling is a standing agreement between people. If nobody wrote the agreement down, it gets negotiated again in conversation whenever one side wants to change something, and a meeting is where that conversation happens.

How does the meeting turn into the change process?

It starts with a surprise. A change goes out and breaks something its author couldn't have known about, owned by someone who wasn't asked. The remedy is obvious and cheap: invite that owner next time. The list grows a name at a time and never shrinks. Dropping someone is a risk with a visible cost. Keeping them costs everybody a little time, and nobody books that.

Then the meeting changes jobs. Early on, attendees tell the proposer what they know. After an owner has been caught out once, they start saying yes or no, because a no is protection and an absence gets blamed. From then on the meeting approves changes. The cadence sets the pace. A change waits for the next slot, gets held over if a question can't be answered in the room, and is bundled with others so it doesn't miss another round. The diagram below draws the sequence and marks the point where informing turns into approving.

DORA's guidance on streamlining change approval (last updated 30 October 2025) says its research shows that approval by an outside body, such as a change advisory board or a senior manager, has a negative impact on software delivery performance, and that no evidence was found that a more formal external review lowers the rate of failed changes. Its explanation is that heavyweight approval slows delivery, so changes are released in larger batches less often, with a higher impact on production when one goes wrong. The same page says a central board is good at broadcasting change, but people far from the work may not grasp its consequences, and it lists responding to problems by adding more process as a pitfall that drives up lead times and batch sizes in a vicious cycle.

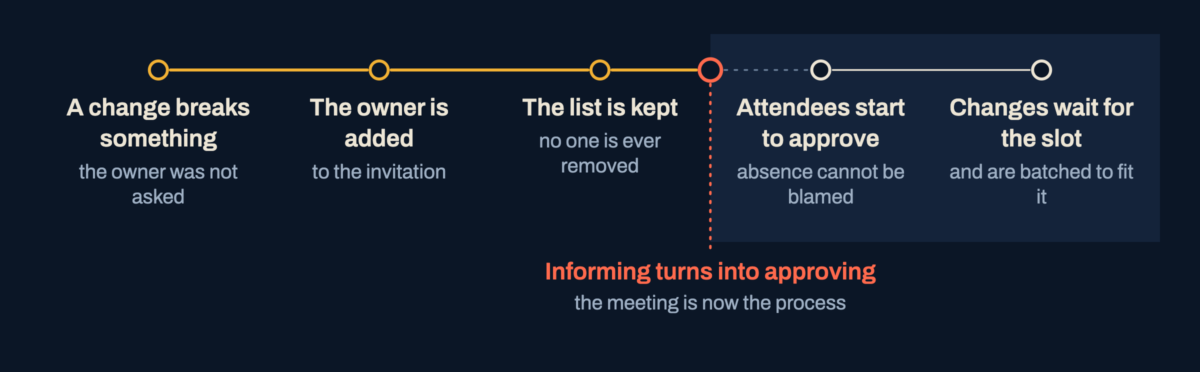

How an invitation list becomes a change process

A flow of steps from a change that breaks something, through the owner being added and the list being kept, to attendees approving and changes waiting for the slot, with the break where informing turns into approving.
Nobody decides that the meeting becomes the approver. It happens when attending stops being a courtesy and becomes a protection.
Read this as text

Steps, left to right. A change breaks something, and the owner was not asked. The owner is added to the invitation. The list is kept, and no one is ever removed. These first steps are drawn in blue. A terracotta mark follows, labeled informing turns into approving, with the note that the meeting is now the process. Then attendees start to approve, because absence cannot be blamed. Finally changes wait for the slot and are batched to fit it. The last steps are shaded.

Why does fragility produce meetings instead of repairs?

A repair is a project. It needs a sponsor, a scope and a line in a budget. A meeting needs an invitation. After an incident, the meeting is the only response anyone can start the same afternoon, and its cost, the hours of senior people, shows up on no ledger. So the organization buys protection against a fragile system in the one currency it doesn't count. The fragility stays, because a meeting catches errors by asking people whether they can think of one, and the fragility consists of nobody being able to think of them all.

There's a legitimate need underneath. A common requirement is that someone other than the author approves a change. DORA calls this segregation of duties and says peer review can meet it, with reviews, comments and approvals captured in the team's development platform and backed by early, automated detection and fast feedback. What the requirement asks for is evidence of authorization, and a recorded second pair of eyes provides it.

What does a change approval meeting look like at a telecoms operator?

This is a composite from telecoms, not one client. An operator wants to change how a tariff rule applies to customers who move between plans partway through a billing cycle. The rule lives in the billing system, is copied into provisioning, shown in the customer portal and read by a revenue report. The proposer books the change meeting and brings the billing owner. The provisioning owner asks about part-period charges and nobody in the room can answer, so the item is held over while someone tracks down the portal's developer, who is away, and the report's owner, who learns of the change from the minutes. A change that took an afternoon to build takes repeated cycles to approve, and each cycle adds an attendee.

The meeting is a sensible tool pointed at the wrong job: a lookup of facts, done by hand, over and over.

What is the meeting actually doing?

Next time you sit in a change meeting, sort what's said, the way the diagram below does. Some of it is a fact about a dependency: the portal reads that field. That belongs in a written contract between the parts, because it will still be true next month. Some is a judgment about risk: nothing touches that during month-end close. That belongs to a named owner with a stated rule, so it can be applied without convening anyone. Some is news: that job moves on Thursday. That's a notice, which you send and don't discuss.

What's left over is the fact that only one person holds. It tells you what is wrong with the system, because it is the fragility itself. Write it down at once, then ask why only one person knew it.

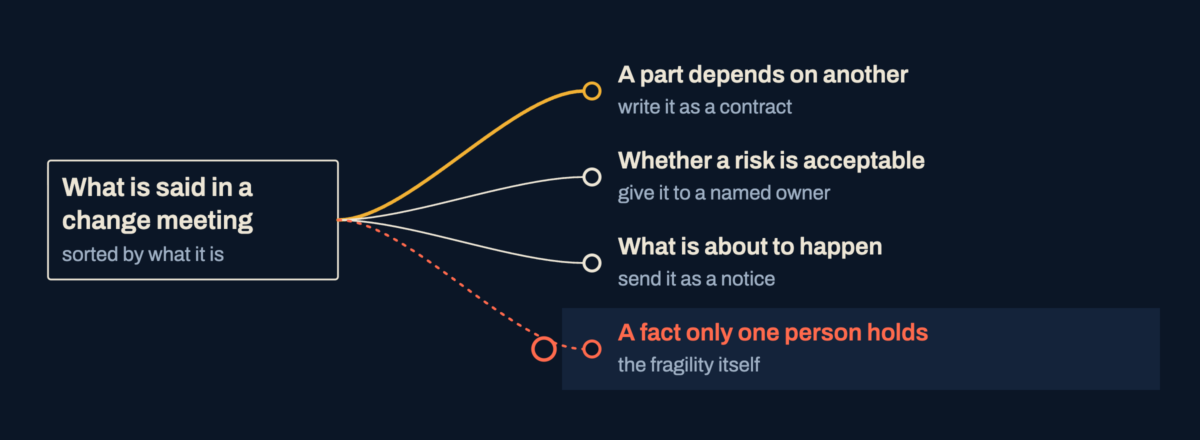

What gets said in a change meeting

What is said in a change meeting sorted into dependencies, risk judgments, news and a fact only one person holds.
Only the last kind needs a person in the room, and not for long. The rest have better homes than a meeting.
Read this as text

One box on the left, what is said in a change meeting, sorted by what it is, splits into branches. A part depends on another: write it as a contract; this branch is blue. Whether a risk is acceptable: give it to a named owner. What is about to happen: send it as a notice. A fact only one person holds: the fragility itself; this branch is terracotta and shaded.

What lets a team approve its own changes again?

Boundaries with contracts. A team may change anything inside its own part so long as the contract it keeps with the other parts still holds. The contract says what crosses the boundary, in what form and with what meaning, and what each side may assume. Parnas's 1972 criterion for dividing a system is that each module hides one design decision from the rest, so a change to that decision stays inside one module. A contract applies the same idea between teams.

Contracts become enforceable through tests and a living map. A contract test that fails when an output changes form gives the team the answer a meeting would have given, without calling anyone. The map of dependencies lives where changes are made and is updated by the same change. DORA points the same way: peer review and automated checks close to the work, and a central board whose role shifts to coordination, process improvement and the trade-offs that need sign-off higher in the business.

The meeting stays, for changes to a contract and for decisions that need a trade-off made above the team. It gets smaller, and who needs to attend is known in advance. To test yours, ask each attendee of the last change meeting what would have happened if they hadn't come. The answer is either a dependency you can write down or a habit you can stop.
